Share The Big Jump on FacebookShare The Big Jump on TwitterShare The Big Jump on LinkedinEmail The Big Jump link
The Big Jump was initiated by community partners in order to create safe and comfortable pedestrian and bicycle connections between and within Reservoir Hill and Remington, two historic neighborhoods separated geographically by I-83, and which each have significant amenities such as parks, trails, employment opportunities, and local businesses. The merits of creating these connections won the project a Big Jump grant from the nonprofit People for Bikes, which provided technical resources to the project team. The Baltimore City Department of Transportation completed the design and construction portions of the project.

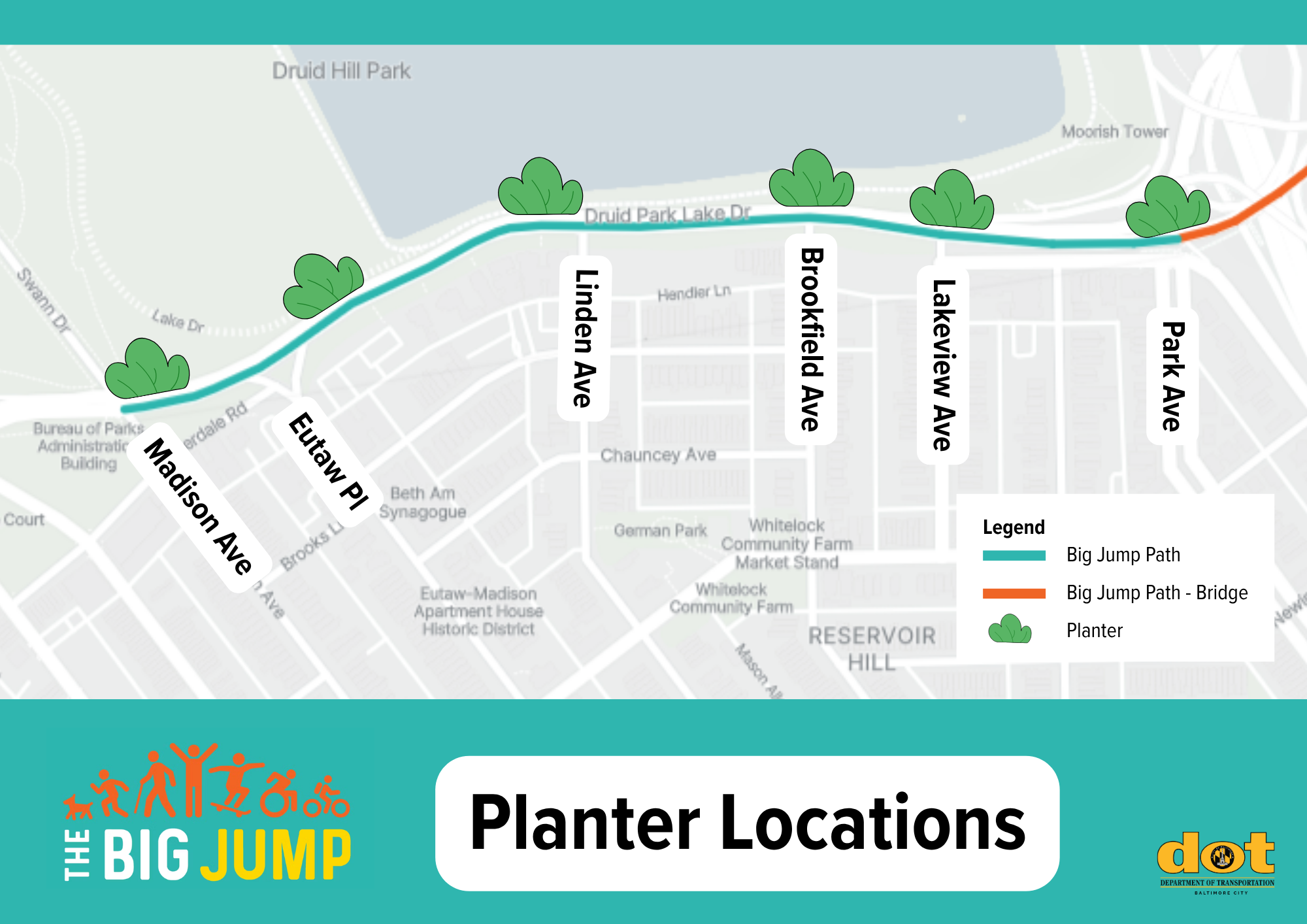

The primary facility that the project created was a temporary “pop up” mixed-use trail along Druid Park Lake Drive proceeding west from Madison Street, across the 28th Street Bridge, and along 28th Street to Atkinson Street. Water-filled or concrete traffic channelization barriers were installed to separate this trail from traffic. A bike lane delineated by flex posts was implemented to run on Sisson Street from 28th Street to Wyman Park Drive; this created a buffer between the sidewalk and motor vehicles and also included intersection improvements at 29th and Sisson to ease crossings for people walking and biking. This installation also successfully reconnected a larger version of the recreational trail loop in Druid Hill Park that remains closed due to construction on the park's reservoir, which has been underway since 2017.
BCDOT held community meetings for the Big Jump project the week of April 23, 2018. Construction of the pop-up trail and bike lane took place in late May 2018.
In 2020, BCDOT released a study that showed the impacts of The Big Jump on mobility on Druid Park Lake Drive. Highlights included:
🚗Delay of 36 seconds at worst for motor vehicles
🚗No impact on parallel routes for motor vehicles
💥Fewer crashes
🛴10-15x usage vs parallel routes for scooters
👍87% of survey respondents wanted the Big Jump to be permanent.
👍 Toole Design, the firm that led the study, recommended improvements to the Big Jump and making it permanent.

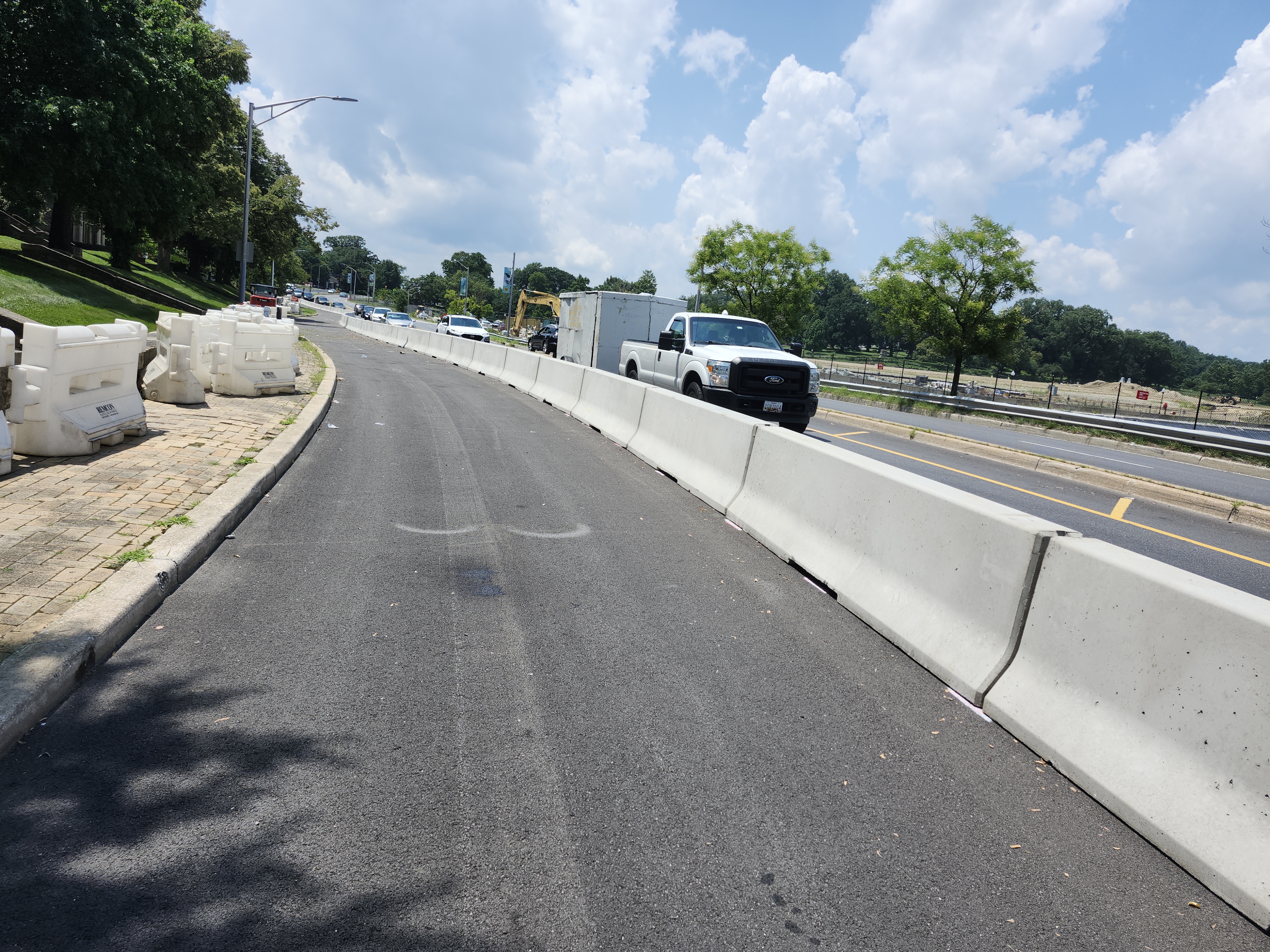

Since installation in June of 2018, BCDOT has intermittently undertaken cleanings of the Big Jump. A more formalized cleaning and maintenance process is in the planning stages as of summer 2023. The Big Jump remains installed in its Quick-Build format indefinitely until a more permanent solution is implemented. Funds were allocated in 2022 in Baltimore City's Capital Improvement Program (FY 2024-29) for more permanent design materials, including concrete barriers. The upgrade of the barriers for the Big Jump Shared Use Path and resurfacing of Druid Park Lake Drive is dependent on the construction schedule of the park reservoir.
The below information is from the pilot project evaluation report prepared by Toole Design for BCDOT, which was published in December 2020.
The Big Jump was initiated by community partners in order to create safe and comfortable pedestrian and bicycle connections between and within Reservoir Hill and Remington, two historic neighborhoods separated geographically by I-83, and which each have significant amenities such as parks, trails, employment opportunities, and local businesses. The merits of creating these connections won the project a Big Jump grant from the nonprofit People for Bikes, which provided technical resources to the project team. The Baltimore City Department of Transportation completed the design and construction portions of the project.
The primary facility that the project created was a temporary “pop up” mixed-use trail along Druid Park Lake Drive proceeding west from Madison Street, across the 28th Street Bridge, and along 28th Street to Atkinson Street. Water-filled or concrete traffic channelization barriers were installed to separate this trail from traffic. A bike lane delineated by flex posts was implemented to run on Sisson Street from 28th Street to Wyman Park Drive; this created a buffer between the sidewalk and motor vehicles and also included intersection improvements at 29th and Sisson to ease crossings for people walking and biking. This installation also successfully reconnected a larger version of the recreational trail loop in Druid Hill Park that remains closed due to construction on the park's reservoir, which has been underway since 2017.
BCDOT held community meetings for the Big Jump project the week of April 23, 2018. Construction of the pop-up trail and bike lane took place in late May 2018.
In 2020, BCDOT released a study that showed the impacts of The Big Jump on mobility on Druid Park Lake Drive. Highlights included:
🚗Delay of 36 seconds at worst for motor vehicles
🚗No impact on parallel routes for motor vehicles
💥Fewer crashes
🛴10-15x usage vs parallel routes for scooters
👍87% of survey respondents wanted the Big Jump to be permanent.
👍 Toole Design, the firm that led the study, recommended improvements to the Big Jump and making it permanent.
Since installation in June of 2018, BCDOT has intermittently undertaken cleanings of the Big Jump. A more formalized cleaning and maintenance process is in the planning stages as of summer 2023. The Big Jump remains installed in its Quick-Build format indefinitely until a more permanent solution is implemented. Funds were allocated in 2022 in Baltimore City's Capital Improvement Program (FY 2024-29) for more permanent design materials, including concrete barriers. The upgrade of the barriers for the Big Jump Shared Use Path and resurfacing of Druid Park Lake Drive is dependent on the construction schedule of the park reservoir.
The below information is from the pilot project evaluation report prepared by Toole Design for BCDOT, which was published in December 2020.
Public meetings for Big Jump Shared Use Path completed in 2018.
The Big Jump has finished this stage
Constructed in June 2018
The Big Jump has finished this stage
Big Jump introduction to the public via August 2018 Block Party
The Big Jump has finished this stage
Project evaluation report published December 2020
The Big Jump has finished this stage
The BCDOT conducted an evaluation of the project, which included a public survey and data analyses. To view full report please click on the link below.
Capital Improvement Program (CIP) funds allocated in 2022, Assigned CIP # 508-146, Big Jump Conversion/Druid Park Lake Drive
The Big Jump has finished this stage

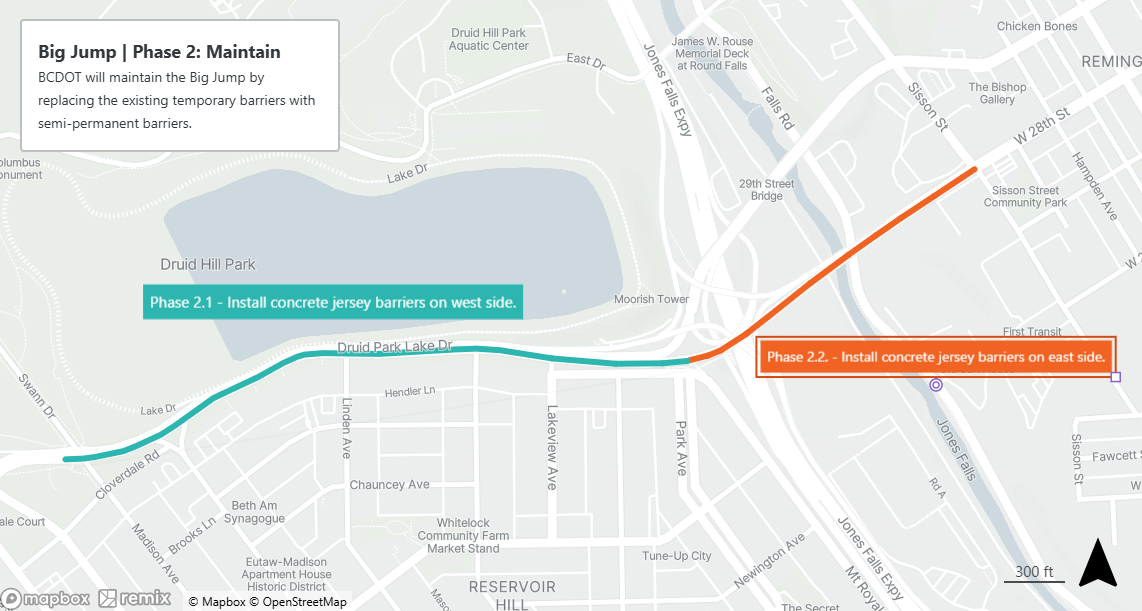

In June 2021, the city allocated $300,000 in General Obligation Bond funds to CIP # 508-146, Big Jump Conversion/Druid Park Lake Drive. The CIP description states maintain walking & biking access via a shared use corridor on Druid Park Lake Drive & W. 28th Street Bridge by replacing existing water filled barriers with semi-permanent solution. Design & implementation will be led by Big Jump evaluation results. These improvements would take place on Druid Park Lake Drive from McCulloh St to Sisson St.
Coordination with Druid Park Reservoir Construction Schedule
The Big Jump has finished this stage
In order to move forward with the installation of semi-permanent materials (CIP# 508-146), continued coordination is needed with the city agencies on the Druid Park Reservoir project's completion.
Resurfacing of Druid Park Lake Drive
The Big Jump is currently at this stage
Repaving and restriping of Druid Park Lake Drive within the Big Jump extents is scheduled for completion by end of August 2024.
Big Jump Conversion Feasibility Study
this is an upcoming stage for The Big Jump
Consultant report on alternatives evaluation for enhancing existing infrastructure on the Big Jump.
Realignment/replacement of temporary barriers (Date TBD)
this is an upcoming stage for The Big Jump
Procurement of semi-permanent barriers (Date TBD)
this is an upcoming stage for The Big Jump
Installation of Semi-Permanent Barriers (Date TBD)
